Anuj Traders

14 Refractory Installation Mistakes That Cost You a Campaign

Installation · Site practice · Quality control · Castables · 13 min read

Draft — pending technical review. Figures are sourced but not yet signed off for publication.

Most refractory linings that fail early were not badly specified. They were badly installed — an extra bucket of water, an anchor in the wrong plane, a joint that had nowhere to grow. These are the fourteen site-level mistakes that turn a good material into a short campaign.

A refractory material arrives on site with its properties defined on paper. Whether the lining ever has those properties is decided over the next few days by people working at height, in heat, against a shutdown clock. That is where most avoidable campaigns are lost.

None of the fourteen mistakes below require new equipment or extra budget to fix. All of them are common.

Before the first bag is opened

1. Storing cement-bonded material badly, or too long

Castables, mortars and grouting cements contain hydraulic cement. Cement reacts with atmospheric moisture, and once it has, no amount of care during mixing recovers the lost bond strength. A bag that has gone lumpy is not "still fine if you break the lumps up."

  • Store on pallets, off the floor, away from external walls, under cover.
  • Respect the shelf life on the bag. In humid Indian conditions the practical shelf life of a cement-bonded product is often shorter than the printed one, not longer.
  • Use oldest stock first, and record which batch went into which zone.
  • Keep fibre products dry and in their packaging until the moment of use; compressed blanket and modules that have been rained on lose their thermal performance and are unpleasant and unsafe to handle.

Why it matters: a lining mixed from stale castable can look and place perfectly and still develop half the intended strength.

2. Mixing product families or "topping up" with whatever is open

A conventional castable, a low-cement castable and a plastic refractory are different chemical systems with different water demands, set behaviours and dryout requirements. Blending them — even to finish a small area, even from the same manufacturer — produces a section with no known properties. The same applies to adding cement, sand, fireclay or "a little mortar" to improve workability. Anything not in the bag is a contaminant.

3. Not preparing the substrate and anchors

Old refractory, scale, oil, loose rust and residual salts all prevent a bond and can chemically attack a fresh lining. Shell surfaces should be cleaned to the specified standard. Anchors must be inspected, replaced where oxidised or distorted, and welded properly — a lining held by anchors with cracked welds is already a demolition job.

Mixing and placing

4. Adding water by eye

This is the single most damaging habit on any refractory site. Water is measured, not judged. Reported figures put the penalty at roughly 20% loss of strength for 1% excess water, rising to 25–40% at 1.5% excess. Too much water raises porosity and permeability, lowers density and strength, extends the set, and leaves more water to remove during dryout. Too little water gives an unplaceable mix that traps voids.

Figure 1 — what a bucket of extra water costs

Strength lost to excess mixing water

Datasheet water, measured

baseline

1% excess

20%

1.5% excess

25–40%

0%45%
Reported strength loss, from the figures cited in this article's sources. And strength is only half of it — porosity and permeability rise with the water, which is the route slag, alkali and molten metal take into the lining months later.

Practical controls:

  • Use a calibrated measuring container, one per batch — never a hose "until it looks right".
  • Work in percentage of dry weight, from the datasheet range, and record the actual figure for each batch.
  • Use clean, potable water. Site water contaminated with oil, salt or organics interferes with the cement.
  • Allow for the temperature of the water and the mix. Hot material and hot water accelerate the set and tempt the crew into adding still more water to recover workability.
  • Never re-temper. Adding water to a mix that has started to stiffen destroys it. Discard it.

5. Hand mixing, or mixing for the wrong time

Castables need a paddle or forced-action mixer; a drum mixer or a shovel and tray will not disperse a modern low-cement matrix.

Figure 2 — a widely used sequence

Dry first, then most of the water, then only what is needed

  1. 1

    Dry mix ≈2 minutes

    Disperses the fines and the deflocculant before any water reaches them. Skipping this is what leaves dry pockets in the placed lining.

  2. 2

    Add ≈80% of the target water, mix ≈3 minutes

    Measured against the datasheet range as a percentage of dry weight — and recorded for the batch.

  3. 3

    Add the remainder only if needed

    To reach the required consistency, and no further. This is the step that quietly becomes "a bit more" and takes 20% of the strength with it.

Under-mixing leaves dry pockets and unactivated deflocculant; over-mixing heats the mix and shortens the working time. Mixer bowls must be clean between batches, and batch size must match how fast the crew can actually place it.

6. Placing without proper vibration or consolidation

Vibration is what converts a mix into a dense lining. Poor consolidation shows up as higher porosity, lower density and reduced strength — and porosity is the route by which slag, alkali and molten metal get into the lining later. A well-vibrated cast section reaches a meaningfully higher bulk density than a loosely placed one of the same material, and that density difference is essentially your corrosion resistance.

Common errors: too few vibrator insertion points; vibrating the formwork instead of the material; leaving the vibrator in one place until the mix segregates and water rises to the surface; and placing in one deep pour rather than in controlled lifts.

Figure 3 — where the properties are decided

Formwork, measured water, a poker vibrator

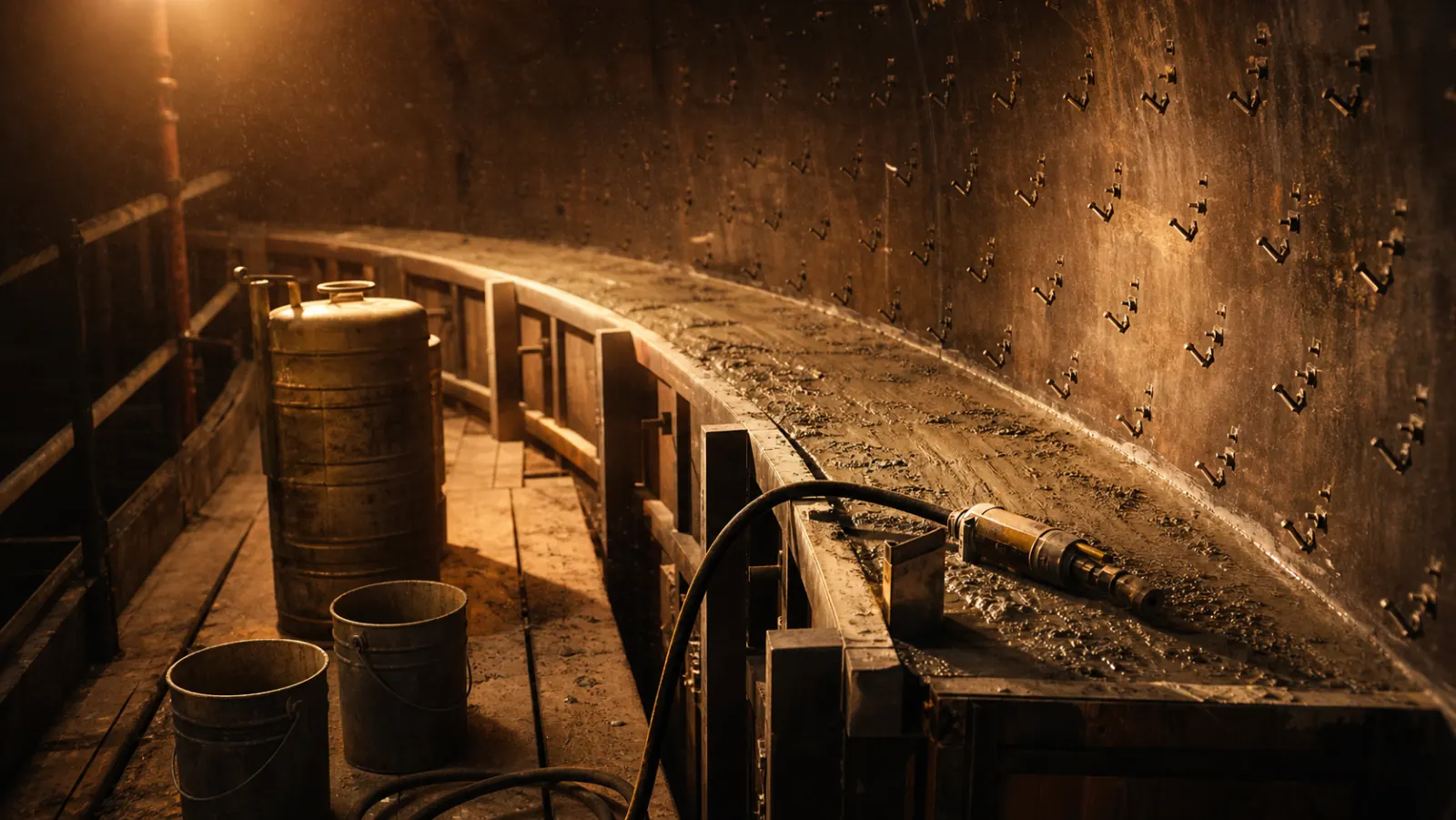

Interior of a vessel being lined: curved plywood and steel formwork against the shell, freshly placed castable visible in the open top of the form, a pneumatic poker vibrator laid across the form edge, a calibrated water drum and buckets on the scaffold boards, and a dense field of stainless anchors welded to the exposed shell.
Illustrative render. Four of the fourteen mistakes on this page are visible as decisions in a photograph like this one: how the water was measured, how many insertion points the vibrator got, whether the form is sealed, and whether those anchors are the grade and orientation on the drawing.

7. Cold joints and unplanned interruptions

A pour that stops for longer than the material's working time and then resumes creates a cold joint — a plane of weakness with none of the surrounding material's strength. Plan pours so each section is continuous, keep a second mixer or a spare available, and if an interruption is unavoidable, form a deliberate joint at a sensible location rather than leaving a random one in the middle of a wall.

8. Formwork that leaks, moves or cannot be removed

Formwork must be rigid, sealed against grout loss, and released with a non-contaminating agent. Leaking forms let water and fines escape, leaving a porous, weak face exactly at the hot side. Forms stripped too early damage green material; forms left too long act as a vapour barrier during early dryout.

Design details that get executed wrong on site

9. Anchors in the wrong place, wrong plane or wrong grade

Anchors hold the lining to the shell and resist the internal stresses that build up at temperature. Their spacing and orientation are part of the lining's mechanical design, yet in everyday practice spacing is very often set by rule of thumb rather than by the actual high-temperature strength of the anchor and the lining — which is why anchoring is one of the most common root causes of failures blamed on materials.

Figure 4 — five checks, five substitutions

Anchors: what the drawing says, and what turns up

As specifiedThe site substitution — and how it fails
GradeAustenitic stainless selected for service temperature — AISI 304, 309, 310 are typical, higher grades for higher dutyMild steel or a lower grade "because that is what was available" → oxidises away and releases the lining
DepthTip within the lining thickness as specifiedTip proud of the hot face → oxidises off and leaves a hole straight through
OrientationV- and Y-anchors alternated or oriented as drawnAll installed in one plane → a continuous crack plane, built in deliberately
Tip treatmentCoating or cap where the design calls for one, to accommodate differential expansionOmitted as cosmetic → the anchor loads the lining instead of holding it
DensitySpacing per drawing, changing at corners, transitions, roofs and openingsFlat-wall pattern copied into a transition → a known failure point
Anchor spacing in everyday practice is very often set by rule of thumb rather than by the actual high-temperature strength of the anchor and the lining, which is why anchoring is one of the commonest root causes of failures blamed on materials.

10. Expansion joints omitted, misplaced or filled with the wrong thing

Refractory grows when it is heated. If it has nowhere to grow, it crushes itself or buckles off the wall. Closed expansion joints and crushed brick edges with sound material behind them are the classic signature.

The mistakes: leaving joints out of a monolithic lining entirely; placing them where they are convenient rather than where the stress needs relief; making them the wrong width for the material's thermal expansion and operating temperature; and packing them with mortar or castable, which is the same as not having a joint. Compressible ceramic fibre is the usual filler for a reason.

11. Brick joints too thick, or the wrong mortar

Bricklaying failures are mostly joint failures. Joints should be as thin as the brick tolerance allows and fully filled — a thick joint is a small castable section with the lowest strength and highest permeability in the wall, and it will be where alkali salts condense and where spalling starts. Match the mortar grade to the brick (an alumina level appropriate to the brick and duty), use heat-setting or air-setting types as specified rather than interchangeably, and do not let a crew "butter" joints thick to correct for poor coursing.

12. Ignoring the transition between different materials

Most linings are systems: dense hot face, insulating backup, fibre or calcium silicate against the shell. Failures cluster at the interfaces, not in the middle of a layer.

Figure 5 — the interfaces, not the layers

What goes wrong between one material and the next

Process side

  • Hot face

    Grows on heating — and something has to absorb that growth

    If the expansion joints are closed or mortared over, the growth is absorbed by whatever is behind it

  • Interface 1

    The failure plane

    Backup insulating castable crushed by the hot face's expansion — and then blamed for a hot shell

  • Backup insulation

    Insulate, and support the hot face

    Insulating castable or insulating firebrick, at its designed thickness

  • Interface 2

    The heat leak

    Board and blanket joints lined up straight through the thickness — stagger them, in both directions

  • Shell insulation

    Keep the shell cool

    Fibre compressed to half its thickness to make the brickwork fit has lost most of its insulating value

Shell

Two rules cover almost all of it: stagger the joints between layers, and never let a soft layer absorb a hard layer's dimensional error. Both are free on the day and expensive six months later.

Commissioning and handover

13. Rushing cure and dryout

Covered fully in the dryout and heat-up guide, but it belongs on any list of installation mistakes because it is where the previous twelve get punished. In short: cover and cure the lining, keep vent and weep holes clear, follow the manufacturer's ramp-and-hold schedule for the products actually installed, control on refractory surface temperature rather than air temperature, and never seal the surface before the water is out.

14. No records, so no learning

The most expensive mistake of all, because it guarantees the next one. A basic installation record costs an hour and pays for itself the first time a lining underperforms:

Figure 6 — one hour, once

The installation record

Without this, a post-mortem can only speculate and the material gets blamed by default. With it, the mechanism is usually obvious.

What went in

Conditions

As built

Without this, a post-mortem can only speculate, and the material gets blamed by default. With it, the mechanism is usually obvious — see how to read a failed lining.

A one-page site checklist

Figure 7 — work through it on the day

The one-page site checklist

Tickable in place — the boxes are live, so you can run down this list on a phone at the vessel. Nothing on it needs equipment you do not already have.

Before the first bag

Mixing and placing

Joints and details

Commissioning

What to send us before an installation

  • lining drawing or sketch with thicknesses by zone and material by layer
  • the products being installed, and where each one goes
  • anchor and expansion joint details, if they exist
  • who is installing, and what mixing and vibration equipment they have
  • your shutdown window and the ambient conditions expected (monsoon, peak summer)

We supply the materials — dense and insulating castables, plastic refractories, mortars and grouting cement, brick, ceramic fibre and calcium silicate — and we would rather flag a mismatch between the plan and the products in advance than supply against a plan we know will not hold.

FAQs

How much water should I add to refractory castable?

Only what the product datasheet specifies for that grade, measured by weight or calibrated volume as a percentage of dry material, and mixed in stages. There is no universal figure — low-cement castables need considerably less water than conventional ones, and the acceptable band for a given product can be narrow. Excess water is reported to cost roughly 20% of strength per 1% excess.

Can I add water to a castable that has started to set?

No. Re-tempering a stiffening mix breaks the developing bond and produces permanently weak material. Discard the batch and size the next one to what the crew can place in the working time.

Do I need vibration if the castable is self-flowing?

Self-flowing grades are formulated to consolidate under their own weight and are usually specified as no-vibration or light-vibration products — follow the datasheet, because vibrating a self-flowing mix can cause segregation. For conventional vibration-cast grades, proper vibration is not optional: it is what delivers the density that resists corrosion.

How thick should refractory brick joints be?

As thin as the brick tolerances allow while being completely filled. Thick joints are the weakest, most permeable part of the wall and are where alkali and sulphur salts condense and where spalling typically initiates.

What grade of steel should refractory anchors be?

Austenitic stainless steel selected for the design temperature — 304, 309 and 310 are typical grades, with higher grades for higher temperature service. The grade, spacing and orientation should come from the lining design, not from site availability.

Is it worth hiring a specialist refractory crew?

For anything monolithic, anchored or on a critical path, yes — and the reason is this list. The material is a small fraction of the cost of an unplanned reline. What matters most is that whoever installs works to the datasheets for the products actually supplied, and records what they did.


Anuj Traders supplies refractory materials and application support from Ahmedabad, as an authorised dealer and distributor for Calderys, Unifrax and Shubh Ceramics. Send us your lining details and we will review the installation plan against the products going in.

Products referenced

Sources

  • Installation of Monolithic Refractory and Resulting Properties — Becht: https://becht.com/becht-blog/entry/installation-of-monolithic-refractory-and-resulting-properties/
  • Safeguarding Refractory Installation: 12 Vital Steps to a Flawless Dry-Out — Heat Treat Today: https://www.heattreattoday.com/equipment/heat-treating-accessories/insulation/insulation-technical-content/safeguarding-refractory-installation-12-vital-steps-to-a-flawless-dry-out/
  • A critical analysis of anchor spacing in refractory lining design — ResearchGate: https://researchgate.net/publication/301198273_A_critical_analysis_of_anchor_spacing_in_refractory_lining_design
  • Anchor Design for Refractories: What You Need to Know — E&MJ: https://www.e-mj.com/departments/processing-solutions/anchor-design-for-refractories-what-you-need-to-know-by-dan-szynal/
  • Refractory Design, Installation, and Maintenance — Springer: https://link.springer.com/chapter/10.1007/978-3-030-21340-4_6
  • Curing and Dryout of Refractories — HWI: https://thinkhwi.com/curing-dryout-refractories/

Keep reading
